← Home · Laboratory

Proctor Testing in Swords: Reliable Soil Compaction Verification

Together, we solve the challenges of tomorrow.

LEARN MORE →

Swords has transformed from a monastic settlement into one of Ireland’s fastest-growing commuter towns, pushing development onto glacial tills and alluvial soils that require rigorous compaction control. Whether the project involves a residential extension on Rathbeale Road or bulk earthworks near Airside Retail Park, the Proctor test establishes the relationship between moisture content and dry density that every site engineer relies upon. Our laboratory determines maximum dry density and optimum moisture content under Standard (BS 1377-4:1990) or Modified compaction effort, giving contractors the target values needed to meet Specification for Highway Works Series 600. Because glacial tills can vary sharply across a site, we often pair the Proctor test with sand cone density measurements for immediate field verification and with Atterberg limits to confirm that the fine fraction is not excessively plastic. The result is a compaction specification that actually reflects the material being placed, reducing the risk of post-construction settlement in a town where housing delivery targets are among the highest in Fingal.

A one percent shift in moisture content can mean the difference between passing a compaction test and reworking an entire lift—Proctor data eliminates that guesswork.

Methodology and scope

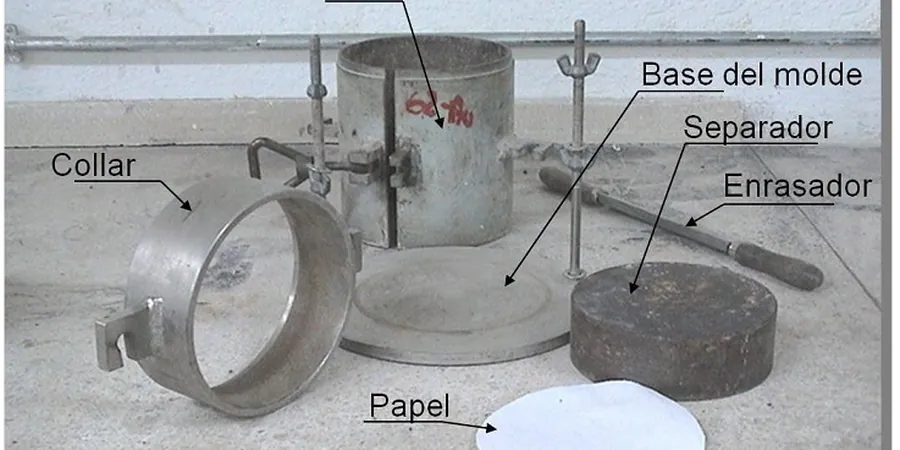

Swords sits at approximately 19 metres above sea level on the northern fringe of Dublin, underlain by lodgement tills that can contain lenses of sand and gravel—perfectly workable material but sensitive to water content during compaction. A single percentage point deviation from optimum moisture can drop relative compaction below the 95% threshold required for structural fill, which is why the Proctor test must be run on material sampled from the active borrow source rather than a nearby borehole. Our lab processes both the 2.5 kg rammer method (Standard Proctor) for general earthworks and the 4.5 kg rammer method (Modified Proctor) for heavily trafficked pavement layers, reporting the zero-air-voids curve alongside the compaction curve so the field engineer can spot oversaturation at a glance. When pavement design calls for a stiffness-based approach, we complement the Proctor with CBR testing to link density to bearing capacity under soaked conditions, an approach that has proven effective on link roads connecting Swords to the M1 corridor. Turnaround is typically three working days from sample receipt, with rush analysis available when the weather window is closing and the next lift of fill needs approval before rain moves in.
Proctor Testing in Swords: Reliable Soil Compaction Verification
Technical reference image — Swords

Local considerations

The Irish climate imposes a narrow compaction window—Swords averages over 750 mm of rainfall annually spread across roughly 190 wet days, so fill material can swing from too dry to saturated within a single week. Contractors who proceed without a current Proctor curve risk either over-compacting dry soil (wasting fuel and creating a brittle fill prone to cracking) or trafficking wet soil that never reaches target density. Over-compacted cohesive fill can develop slickensides that reduce shear strength, while under-compacted granular fill settles differentially under foundation loads, leading to cracked floor slabs and service trench collapse. We have seen projects where imported stone from a Dublin quarry was assumed to compact like the site-won till, only to discover the optimum moisture was three percentage points lower—the entire lift had to be scarified, dried, and recompacted at significant cost. A project-specific Proctor test costs a fraction of that rework and becomes a defensible record when the resident engineer asks for compaction compliance documentation.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnical-engineering.co

Technical parameters

ParameterTypical value
Applicable StandardsBS 1377-4:1990, ASTM D698-12, ASTM D1557-12e1
Compactive Effort (Standard)2.5 kg rammer, 300 mm drop, 27 blows/layer, 3 layers
Compactive Effort (Modified)4.5 kg rammer, 450 mm drop, 27 blows/layer, 5 layers
Mould Sizes Available1-litre (fine soils) and 2.3-litre (granular soils)
Typical MDD Range (Swords Till)1.90 to 2.15 Mg/m³ depending on grading
Optimum Moisture Content Range8% to 14% for local glacial deposits
Report Turnaround3 working days standard; 24-hour rush available
Lab AccreditationISO 17025 by INAB for compaction-related testing

Associated technical services

01

Standard and Modified Proctor Testing

Laboratory determination of maximum dry density and optimum moisture content using BS 1377-4 or ASTM methods, with full reporting including zero-air-voids curve and saturation lines.

02

Field Density by Sand Cone

On-site relative compaction verification using the sand replacement method, directly comparable to the Proctor target to confirm 95% or 98% compaction as specified.

03

Material Suitability and Classification

Grain size analysis, Atterberg limits, and chemical testing (pH, sulfate, organic content) to classify fill material as acceptable or unacceptable under TII Series 600 before compaction begins.

Applicable standards

BS 1377-4:1990 — Compaction-related tests, ASTM D698-12 — Standard Proctor, ASTM D1557-12e1 — Modified Proctor, NRA (TII) Series 600 — Earthworks (Ireland), IS EN 13286-2 — Unbound and hydraulically bound mixtures

Frequently asked questions

What is the difference between Standard and Modified Proctor, and which one does my project need?

Standard Proctor (2.5 kg rammer) simulates lighter compaction equipment and is typical for landscaping, general fill, and low-rise building pads. Modified Proctor (4.5 kg rammer) replicates heavy vibratory rollers and is specified for pavement subbase, runway earthworks, and structural fill under heavily loaded foundations. The project specification—usually referencing TII Series 600 or the structural engineer’s performance requirements—dictates which method to use. We recommend checking the contract documents; if unspecified, Modified Proctor is the safer baseline for any fill supporting vehicular traffic or multi-storey loads in the Swords area.

How much does a Proctor test cost in Swords?

A Standard or Modified Proctor test typically ranges from €80 to €190 depending on the number of points on the compaction curve and whether the material requires pre-treatment such as oven-drying or sieving. Rush turnaround within 24 hours carries a modest surcharge. For multi-source earthworks projects, we offer discounted batch rates when five or more Proctor curves are requested from the same site.

How long does it take to get Proctor results back from the lab?

Our standard turnaround is three working days from receipt of the disturbed sample. The test itself requires controlled drying, moisture conditioning at several water contents, and compaction at each point—processes that cannot be rushed without compromising curve quality. We do offer a 24-hour rush service when the compaction schedule is weather-critical, which is common during Swords winters when dry days are scarce.

Do I need a new Proctor test if the borrow source changes during the project?

Yes, absolutely. The Proctor curve is unique to a specific material; glacial tills in Swords can shift from silty clay to sandy gravel over short distances. If you switch to a different lift, a new borrow pit, or even a deeper horizon within the same excavation, you must run a fresh Proctor test. Using the wrong curve can lead to false passes or false fails on field density tests, and the resident engineer will almost certainly reject compaction records based on an unrepresentative laboratory reference.

Location and service area

We serve projects across Swords and its metropolitan area.

View larger map
